Vehicle datasheetFirst flight mid-2027

Spark-1

A dedicated spacecraft for cargo return from orbit

First flight mid-2027. Your payload can be on it: carried to low Earth orbit on a standard launch vehicle, powered through months of free flight, and back in your hands six hours after landing.

Wireframe drawing of the Spark-1 reentry vehicle in free flight

Mission profile

Spark-1 flies the whole loop autonomously: rideshare launch on a vehicle such as Falcon 9, a de-orbit burn, hypersonic reentry, and a parachute-assisted soft landing at a pre-designated recovery zone, on land or water, with rapid recovery by ship.

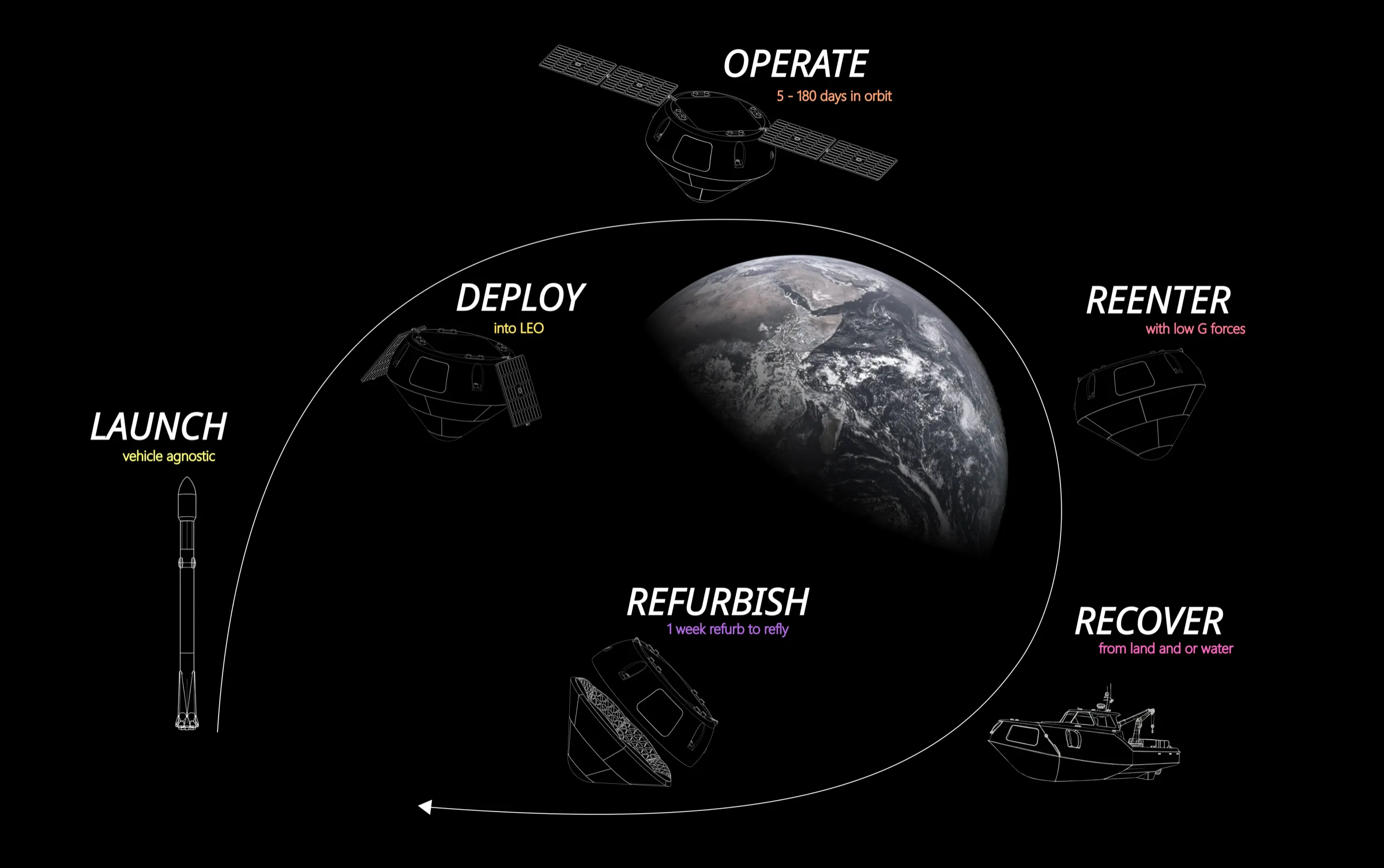

Spark-1 concept of operations: launch, deploy into low Earth orbit, operate 5 to 180 days, reenter with low G forces, recover on land or water, refurbish to refly

Reentry is the hard part.

Hypersonic reentry rides behind heat shields built in-house, Mach 20+ capable, validated at full scale in the Mojave using rocket exhaust. About one week of refurbishment between flights.

launch to deployment
< 30 min
de-orbit to landing
< 30 min
payload back in hand
L + 6 h

Payload interfaces

The conditions behind the cover figures: how a payload mounts, draws power, and moves data, from launch through reentry.

Mechanical & power

Mounting
Preloaded tabs, mounting rails, or M6 fasteners.
Electrical power
28 ± 6 VDC unregulated bus, with 10 A peak for short durations.

Regulated power available on request.

Power availability
Powered throughout on-orbit operations. Unpowered during launch and reentry.

Reentry power available on request.

Connectors & grounding
One 9-pin D-sub for power and one 15-pin D-sub for communications. Grounding through the connector and the mounting interface.

Data & radio

Command & telemetry
RS-422 asynchronous command and telemetry to the flight computer, up to 1 Mbps.

Additional interfaces available on request.

Reentry blackout
Live communication is unavailable for roughly 15 minutes during reentry.
Payload transmitters
Payload-provided transmitters must be declared, approved, and frequency-coordinated with Dispatch and spectrum authorities.

Program

Integration
Payload PDR at L-210 days, delivery to the Dispatch integration facility at L-60 days, and payload access until 24 hours before launch-vehicle integration.
Documentation
For structural design, dynamic and thermal environments, contamination control, and verification testing, start with the Payload User's Guide, the controlling document for every figure on this page.

What flies on Spark-1

First flight

mid-2027

Fly on an early Spark-1 mission.
